Retaining wall approval and engineering requirements in Queensland

By John W  |  Reviewed 2 September 2026

Whether a retaining wall needs building approval cannot be determined from its height alone. The retained cut or fill, nearby buildings and walls, loads above the wall, pool fencing and the planning controls applying to the property can all affect the answer.

This guide explains the main checks for a typical residential project. It does not replace advice from the building certifier, council or the engineers responsible for the particular site.

Key points

  • A wall below one metre can still require building approval.
  • The height, surcharge, separation and pool-fence conditions must be considered together.
  • Building approval and local-government planning approval are separate matters.
  • Work that is accepted development must still comply with the applicable building requirements.
  • A building certifier should confirm the approval pathway before construction.

Building approval and planning approval are different checks

The Building Regulation 2021 identifies particular retaining-wall work that can be accepted development, provided every relevant condition is satisfied. If the work falls outside those conditions, a private building certifier should determine the building-approval requirements.

Local planning schemes deal with different matters. Planning requirements can arise from filling and excavation, overlays, neighbourhood plans, flooding, landslide risk, waterways, heritage controls or other property constraints. A project may therefore satisfy the building-work exemption and still require a planning check with the relevant council.

Do not rely on a verbal “under one metre” rule. Establish the wall geometry and surrounding site conditions, then have the approval pathway checked against the current requirements.

Unsure what applies to your proposed wall? Send us a message, or call or SMS 0450 444 443 with the property address, approximate wall dimensions and a few photographs. We can review the available information and identify matters that may need engineering or certifier input. The building certifier remains responsible for confirming the approval pathway.

The accepted-development conditions

For the provision in Schedule 1 of the Building Regulation 2021 to apply, the relevant conditions need to be read together.

Check What the provision requires Why it matters
Total height The total wall height and the retained fill or cut must be no more than 1 m. Measure the complete retained level difference at the highest relevant location, not an average along the wall.
Surcharge loading There must be no surcharge loading over the wall’s zone of influence. Driveways, buildings, pools, slabs, stored materials and other loads can increase the pressure acting on the wall.
Separation The regulation refers to a minimum separation of 1.5 m from a building or another retaining wall. Show other nearby structures—such as houses, sheds, carports, garages, pools and similar works—so the certifier and engineer can confirm how they are classified and whether the relevant separation requirements are met. Nearby buildings, structures, footings and retaining walls can interact through the ground.
Pool fencing The wall must not form part of the fencing for a regulated pool. Pool barriers are subject to additional safety and compliance requirements.

These conditions deal with a particular building-work exemption. They do not confirm that the proposed wall is structurally suitable, that planning approval is unnecessary, or that work near a boundary, easement or buried asset can proceed without further assessment.

A practical process before design and construction

Confirm the wall position and levels

Prepare a site plan showing the wall alignment, length, maximum retained height and existing and proposed ground levels. Confirm the property boundary where its position affects the work.

Record nearby loads and structures

Show houses, sheds, driveways, pools, fences, other retaining walls and slopes above and below the wall. Include relevant features on adjoining land where they may influence the design or construction.

Check easements, services and site constraints

Review available title, survey and service information. Work over or near sewer, water or stormwater infrastructure can require a separate assessment and authority referral.

Ask the certifier and council the right questions

The building certifier determines the building-approval pathway. The local council administers its planning scheme and can advise whether filling, excavation, overlays or other planning provisions apply.

Complete the engineering and approval before excavation

Finalise the site-specific design, drainage arrangement, approvals and construction access before work starts. Changes to levels or nearby loads should be referred back to the engineer and certifier.

Surcharge loading and nearby retaining walls

Surcharge loading is additional load applied to the retained ground. Depending on its position, a driveway, vehicle, building footing, pool or other structure can increase lateral pressure on the wall.

The zone of influence is the volume of soil that affects the wall’s structural behaviour. It is not a fixed line that can always be established from a photograph. Wall geometry, soil, slope, footing levels and the position of nearby loads all need to be considered.

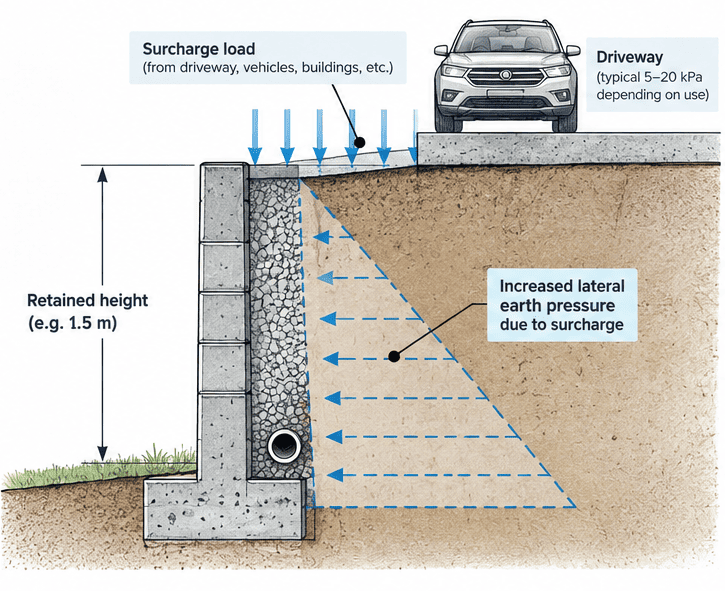

Retaining wall surcharge load from a driveway and vehicle increasing lateral earth pressure
Figure 1. Surcharge above a retaining wall. A driveway, vehicle or building above the retained ground can increase the load on the wall.

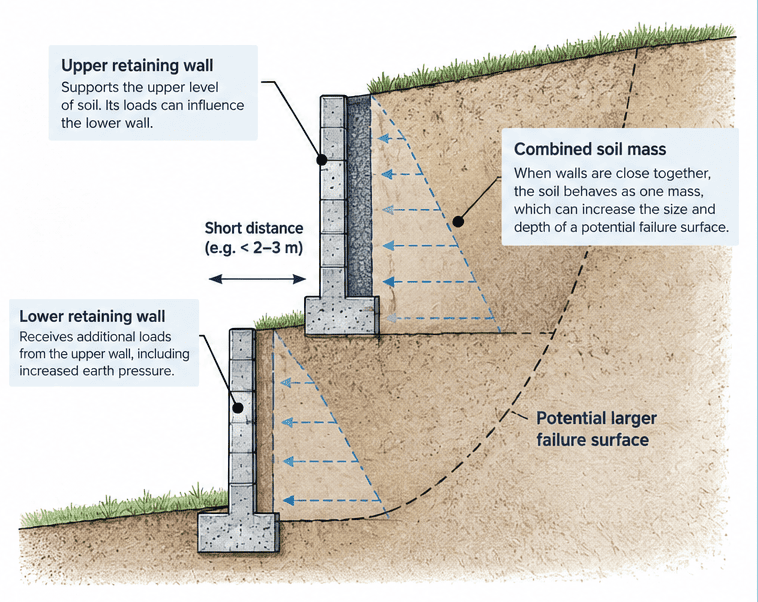

Multiple retaining walls close together acting as a combined soil mass
Figure 2. Interaction between nearby walls. Closely spaced walls may need to be assessed as an interacting retaining system.

Concept figures only. They are not construction details and are not to scale.

Situations requiring closer attention

Site condition Engineering or approval consideration
Driveway or parking area above the wall Vehicle and pavement loading may act within the wall’s zone of influence.
House, shed or pool close to the wall Footings and excavations may interact with the wall and retained ground.
Several stepped walls The height and spacing of every tier should be provided for assessment.
Wall near a boundary Survey, footing position, drainage, construction access and adjoining structures need to be considered.
Wet, sloping or filled ground Groundwater, surface runoff, soil strength and overall slope stability may require specific engineering or geotechnical input.

Who determines each part of the project?

Party Typical responsibility
Structural engineer Assesses loads, stability, footings, materials, reinforcement and drainage assumptions, and prepares the site-specific structural design.
Building certifier Confirms and administers the building-approval pathway and required inspection or certification documentation.
Local council Administers the planning scheme, including applicable filling, excavation, overlay and siting provisions.
Builder or appropriately licensed contractor Constructs the wall to the approved documents and coordinates the required inspections.
Cadastral surveyor Confirms the surveyed property boundary where the wall or its footing is close to it.

Information to prepare

The following information normally allows an engineer or certifier to give more useful initial advice:

  • property address and available site or survey plan;
  • wall alignment, length and maximum retained height;
  • existing and proposed ground levels;
  • clear photographs showing the wall location and broader slope;
  • distances to buildings, driveways, pools and other walls;
  • known boundaries, easements and underground services;
  • the proposed wall type, fence or barrier; and
  • the proposed drainage discharge point.

For more detail about water management, see the retaining-wall drainage guide. Work near buried public infrastructure is discussed in the sewer and stormwater asset guide.

Common questions

Does a retaining wall over one metre require approval?

A wall exceeding the one-metre condition does not qualify under the particular accepted-development provision discussed above. A building certifier should confirm the approval required for the proposed work.

Does a retaining wall under one metre avoid approval?

Not automatically. Surcharge loading, separation from buildings and other walls, pool-fence use and local planning requirements also need to be checked.

Who decides whether building approval is required?

A licensed building certifier should confirm the building-approval pathway. Council should be consulted about planning provisions applying to the property.

Can a standard retaining-wall detail be used?

Only where the detail’s stated limits and assumptions match the site. Height, soil, slope, drainage, surcharge and nearby structures must remain within those limits.

Is a soil test always required?

No single investigation scope suits every wall. The structural engineer may require geotechnical information where bearing capacity, fill, groundwater, slope stability or variable ground conditions cannot be established reliably.

Primary references: Queensland Building Regulation 2021; Brisbane City Council retaining-wall requirements; Brisbane City Council filling and excavation guidance; and QBCC structural landscaping scope.

General information only

This guide provides general information for Queensland and should not be relied upon as an approval, engineering design or construction instruction. Requirements depend on the property, proposed work and current legislation. Confirm the project requirements with the relevant council, a licensed building certifier and appropriately qualified engineers before construction.
